Contract Renewal Tracker

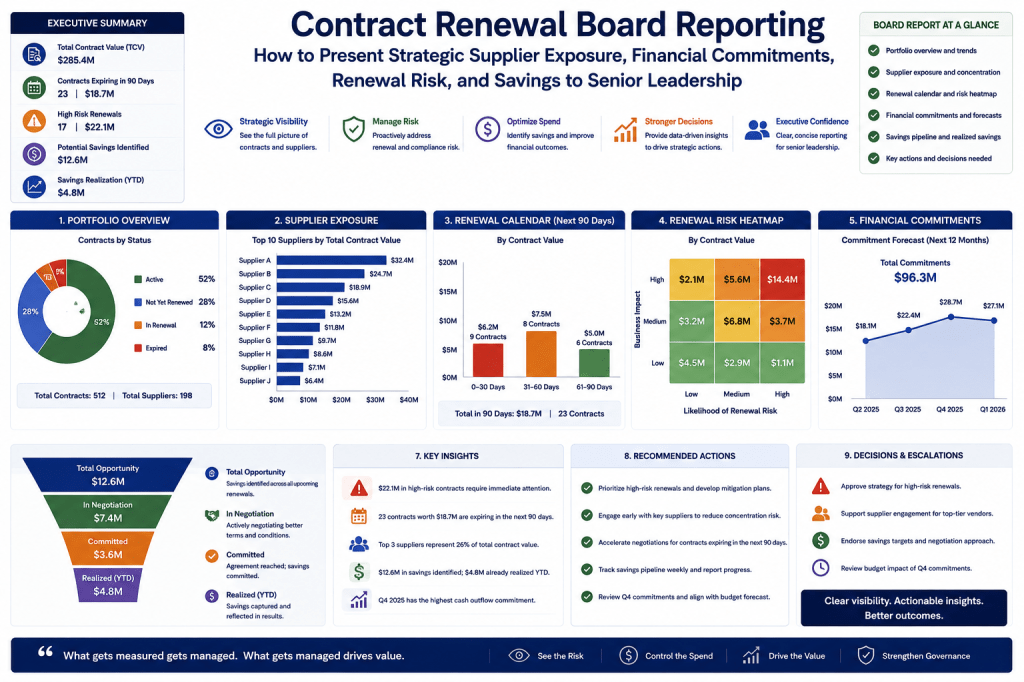

Contract Renewal Board Reporting: How to Present Strategic Supplier Exposure, Financial Commitments, Renewal Risk, and Savings to Senior Leadership

Board reporting should not be a larger version of an operational dashboard.

Boards and executive committees do not need every renewal task, every overdue reminder, or every contract field.

They need a concise view of the issues that could materially affect:

  • financial performance;
  • strategic execution;
  • supplier dependency;
  • operational continuity;
  • legal exposure;
  • cost transformation.

That means contract renewal reporting at board level should focus on materiality, concentration, trend, and required decisions.

A dedicated Contract Renewal Tracker can turn detailed renewal activity into board-ready reporting that answers:

What strategic supplier commitments are approaching, where is the organization exposed, what has changed since the last report, and does senior leadership need to intervene?

Contract Renewal Board Reporting - How to Present Strategic Supplier Exposure, Financial Commitments, Renewal Risk, and Savings to Senior Leadership
Contract Renewal Board Reporting – How to Present Strategic Supplier Exposure, Financial Commitments, Renewal Risk, and Savings to Senior Leadership

Why Contract Renewals Belong in Senior Leadership Reporting

Not every renewal belongs on a board agenda.

A €5,000 software subscription does not.

But a €25 million cloud agreement, a critical outsourcing renewal, or a major supplier replacement potentially does.

These contracts can affect:

  • cost base;
  • transformation programs;
  • cybersecurity exposure;
  • business continuity;
  • cash flow.

The goal is therefore not:

Report every contract.

It is:

Identify the contract renewal events that are materially relevant to enterprise governance.


Are Strategic Supplier Renewals Visible Before They Become Executive Problems?

Large supplier commitments can remain operational issues for months before suddenly becoming executive issues because a deadline, negotiation, replacement, or approval has gone wrong.

Contract Renewal Tracker is designed to surface those material developments early and convert them into concise, decision-ready leadership reporting.

Turn renewal operations into board-level strategic visibility →


Board Reporting Starts with Materiality

The first question should be:

Which contracts are material enough to report?

A company can define thresholds based on:

  • annual value;
  • total contract value;
  • strategic criticality;
  • supplier concentration.

For example:

Financially Material

TCV > €5M.

Strategically Material

Critical infrastructure regardless of value.

Risk Material

High/Critical renewal with significant operational impact.

This creates a manageable reporting population.


Materiality Is Not Only Financial

A €200K cybersecurity service may be more strategically important than a €2M commodity supplier.

Board reporting should therefore consider both:

Value

and:

Business Criticality

This prevents smaller but essential suppliers from disappearing from view.


Materiality Matrix

A simple model:

Low CriticalityHigh Criticality
Low ValueOperationalRisk-Based Review
High ValueFinancial ReviewBoard / Executive Attention

This helps define escalation.


Board Reporting Metric 1: Strategic Renewal Exposure

A useful opening metric is:

Value of material contracts renewing within the next 12 months

For example:

Strategic renewal exposure:

€180M

That immediately establishes scale.


Break Exposure by Horizon

For example:

Next 90 Days

€24M.

Next 180 Days

€65M.

Next 12 Months

€180M.

This tells leadership when major commitments are approaching.


Strategic Exposure Should Be Compared with Total Spend

If annual third-party spend is:

€500M

and:

€180M renews next year,

36% of supplier spend is potentially subject to renewal decisions.

That is strategically meaningful.


Board Reporting Metric 2: High-Risk Strategic Renewals

Do not simply report:

12 high-risk contracts.

Report:

€42M of strategic renewal exposure is High or Critical risk.

This gives the risk financial context.


High-Risk Breakdown

For example:

Deadline / Notice Risk

€8M.

Negotiation Risk

€14M.

Replacement Risk

€12M.

Supplier / Security Risk

€8M.

This tells leadership what kind of exposure exists.


Top Material Renewals

A board-level table may include only five or ten items.

For example:

SupplierCommitmentStatusKey Issue
CloudCo€32MNegotiation+14% supplier proposal
OutsourcingCo€25MReplaceTransition delayed
CyberSecure€8MHigh RiskSecurity remediation
TelecomCo€12MNegotiationConsolidation opportunity

This is enough for discussion.


Board Reporting Metric 3: Strategic Supplier Concentration

Supplier concentration can create systemic dependency.

For example:

Top 5 strategic suppliers:

42% of critical technology spend

That deserves senior visibility.


Concentration by Supplier

For example:

Cloud Supplier A:

18%.

ERP Supplier:

11%.

Managed Services:

8%.

Cybersecurity:

5%.

This shows where dependency is concentrated.


Concentration Plus Renewal Timing

Even more useful:

70% of Cloud Supplier A’s €24M annual relationship renews within the next six months.

That creates both:

  • negotiation leverage;
  • strategic risk.

This is board-relevant.


Single-Supplier Dependency

A board may want to know:

Which critical capabilities rely on one supplier with limited alternatives?

For example:

Core ERP:

High dependency.

Replacement lead time:

24 months.

This helps frame renewal strategy.


Board Reporting Metric 4: Multi-Year Financial Commitments

Renewal value should not be reported only on an annual basis.

Example:

Annual value:

€8M.

Five-year term:

€40M commitment.

The board may care more about the latter.


Annual Spend vs TCV

A board report should distinguish:

Annual Cost

from:

Total Contractual Commitment

This avoids understating long-term obligations.


New Commitments During Reporting Period

For example:

Approved during quarter:

€72M TCV.

This provides a view of new long-term supplier commitments entered into.


Commitment Maturity Profile

A useful view might show:

1-Year Commitments

€30M.

2–3 Years

€90M.

4+ Years

€140M.

This reveals long-term lock-in.


Board Reporting Metric 5: Contractual Flexibility

Senior leadership may want to understand:

how much supplier spend is locked into long-term agreements.

For example:

Spend under >36-month commitments:

€120M.

Strategic suppliers:

€95M.

This is a useful flexibility metric.


Lock-In Exposure

Long-term commitments are not necessarily bad.

But if technology or strategy is changing rapidly, excessive lock-in can constrain the business.

Renewal reporting can make this visible.


Board Reporting Metric 6: Supplier Inflation Exposure

For example:

Strategic supplier proposals:

Average increase:

9.4%.

Current procurement expectation:

4.8%.

Potential gross annual increase:

€6.2M.

This is relevant to financial planning.


Proposed vs Expected

A board report can show:

Supplier Ask

+€6.2M.

Expected Negotiated Outcome

+€3.1M.

This demonstrates both pressure and procurement response.


Price Inflation by Strategic Category

For example:

Cloud:

+11%.

Software:

+8%.

Managed Services:

+5%.

This gives leadership context.


Board Reporting Metric 7: Renewal Savings

Savings should be presented carefully.

A board does not need every methodology detail.

But it should distinguish:

Hard Savings

Cost Avoidance

Avoided Spend

For example:

Hard Savings YTD

€4.2M.

Cost Avoidance

€7.1M.

Avoided Spend

€2.4M.

This avoids inflated “total savings” claims.


Savings vs Target

For example:

Annual hard-savings target:

€5M.

Realized:

€4.2M.

Forecast:

€5.4M.

Status:

On Track.

This is concise and useful.


Savings Should Be Finance-Validated

For board reporting, use:

validated

or:

realized

financial outcomes where possible.

Avoid presenting early pipeline opportunities as achieved value.


Board Reporting Metric 8: Unwanted Renewal Avoidance

This is a strong operational outcome.

For example:

Contracts prevented from unwanted auto-renewal:

Annual spend avoided:

€1.8M.

This can demonstrate control effectiveness.


Missed Renewals

The board may also need to know if material failures occurred.

For example:

Material missed renewal deadlines:

Or:

Associated financial impact:

€350K.

Material exceptions should be transparent.


Board Reporting Metric 9: Major Supplier Replacements

A significant supplier replacement can create:

  • continuity risk;
  • transformation dependencies.

The board may need a status summary.


Example Replacement Report

Supplier:

Legacy ERP Provider.

Replacement:

NewERP.

Current status:

Migration 78%.

Old contract ends:

March 31.

Forecast go-live:

February 15.

Buffer:

44 days.

Risk:

Medium.

This is enough for executive oversight.


Transition Risk Should Be Reported as Exceptions

No need to report every project milestone.

Only report:

  • material delays;
  • predicted service gaps;
  • major bridge costs.

This keeps the report strategic.


Board Reporting Metric 10: Bridge Extensions

Unexpected bridge extensions may indicate:

  • project delay.

For example:

Emergency extensions YTD:

Incremental cost:

€1.2M.

This could be relevant if material.


Board Reporting Metric 11: Supplier Performance

For major strategic suppliers:

report where performance is below expectation.

For example:

Strategic supplier spend below performance threshold:

€22M.

This gives leadership a vendor-quality view.


Supplier Performance Trend

For example:

Strategic suppliers below score 70:

Q1:

Q2:

Q3:

Improving.

This may be more useful than raw detail.


Board Reporting Metric 12: Third-Party Risk

Major supplier risks may include:

  • cyber;
  • financial instability;
  • regulatory issues.

A board report could say:

Two strategic suppliers totaling €18M annual spend are currently classified High third-party risk and enter renewal within six months.

That is decision-relevant.


Board Reporting Metric 13: Compliance Exceptions

Senior leadership may need visibility into material control exceptions.

For example:

Renewals Executed Without Required Approval

Material Notice Exceptions

Segregation-of-Duties Exceptions

This demonstrates governance.


Policy Exception Trend

For example:

Q1:

Q2:

Q3:

This shows improving process maturity.

Only material trends may belong in board reporting.


Board Reporting Metric 14: Budget Impact

The board may see:

Current renewal forecast:

€84M.

Budget:

€82M.

Variance:

+€2M.

Main drivers:

supplier inflation and delayed replacement.

This gives immediate financial context.


Budget Bridge

Example:

Budget:

€82M.

Supplier Inflation:

+€4M.

Growth:

+€2M.

Savings:

−€3M.

Terminations:

−€1M.

Expected:

€84M.

This is an excellent senior-level financial narrative.


Board Reporting Metric 15: Forecast Confidence

If major renewal outcomes remain unresolved, the board should know.

For example:

Forecast Confidence: Medium

because:

€16M of strategic spend remains under negotiation.

This communicates uncertainty responsibly.


Forecast Range

Instead of:

Expected:

€84M.

Use:

Expected:

€84M.

Likely range:

€82.5M–€86M.

This gives leadership a better understanding of potential outcomes.


Board Reporting Metric 16: Decision Requirements

Perhaps the most important section is:

What decisions does leadership need to make?

For example:

Decision 1

Approve 24-month CloudCo renewal.

TCV:

€32M.

Decision 2

Authorize 6-month bridge for outsourcing transition.

Cost:

€2.5M.

Decision 3

Approve replacement sourcing strategy for cybersecurity supplier.

This makes the report actionable.


Keep Decision Requests Separate from Information

A report should clearly distinguish:

For Information

from:

Decision Required

This improves meeting efficiency.


Board Reporting Metric 17: Changes Since Last Meeting

Senior leaders often care more about movement than absolute numbers.

For example:

Since last report:

  • Critical exposure decreased €8M.
  • Forecast cost increased €1.2M.
  • One strategic replacement moved to High risk.
  • Savings forecast improved €700K.

This is an excellent opening summary.


Change Reporting Prevents Repetition

Do not re-present:

the entire portfolio

every month.

Highlight:

what changed

and:

why.

This keeps board packs concise.


Management Commentary

Numbers alone are not enough.

A strong board report includes a short narrative such as:

Strategic renewal exposure remains manageable, with no material missed deadlines. Cost pressure increased due to double-digit software proposals, but procurement savings remain ahead of plan. The main emerging concern is the ERP supplier replacement, where migration delay has reduced the transition buffer to 45 days.

This is much more useful than charts alone.


AI-Generated Board Commentary

Contract Renewal Tracker can generate a draft management narrative from underlying metrics.

For example:

During the quarter, Critical renewal exposure fell from €52M to €38M following completion of two major supplier negotiations. Forecast renewal spend increased €1.2M, primarily due to software inflation. One supplier replacement has moved to High risk because migration milestones slipped.

This can save substantial reporting time.


AI Should Not Invent Executive Interpretation

The narrative should remain grounded in:

  • actual metrics;
  • recorded risks.

It should not create dramatic commentary unsupported by evidence.


AI Board Summary Should Be Reviewed

For formal board materials, a human owner should review AI-generated commentary before publication.

This ensures:

  • accuracy;
  • tone;
  • governance.

Board Reporting Structure

A practical report might include:

Executive Summary

One page.

Strategic Renewal Exposure

Material contracts.

Financial Outlook

Budget, inflation, savings.

Strategic Supplier Risk

Concentration and performance.

Major Exceptions

Transition, legal, compliance.

Decisions Required

Specific approvals.

That is often enough.


Keep the Main Pack Short

The detailed contract data can sit in:

appendix

or:

dashboard drill-down.

Boards need:

decision clarity.

Not:

operational clutter.


One-Page Executive Summary

For example:

Strategic Renewals Next 12 Months

€180M.

High/Critical Risk

€38M.

Forecast Budget Variance

+€2M.

Realized Hard Savings

€4.2M.

Strategic Replacements at Risk

Material Missed Deadlines

Board Decisions Required

This is highly usable.


Trend Arrows

The report might show:

Critical Exposure:

€38M ↓ €14M.

Budget Variance:

€2M ↑ €800K.

Savings:

€4.2M ↑ €1.1M.

This gives instant context.


Strategic Supplier Table

Keep it concise:

SupplierRenewal ValueRiskCurrent Position
CloudCo€32MMediumFinal negotiation
OutsourcingCo€25MHighTransition delay
ERPCo€18MLowApproval
CyberSecure€8MHighSecurity remediation

This is enough for discussion.


Avoid Red-Yellow-Green Without Explanation

A red status alone is insufficient.

Use:

High — transition is forecast 12 days beyond incumbent contract end

That gives meaning.


Risk Should Always Have a Reason

For every material red/amber item:

  • why;
  • owner;
  • next action.

This creates accountability.


Action Owner

For example:

ERP Replacement.

Risk Owner:

CIO.

Next Action:

Executive transition review August 20.

This closes the reporting loop.


Board Materiality Thresholds Should Be Configurable

One organization may report:

contracts >€5M.

Another:

€1M.

Thresholds should depend on:

  • size;
  • governance.

Contract Renewal Tracker can support configurable reporting tiers.


Example Tiering

Tier 1 — Board

€10M or strategic critical.

Tier 2 — Executive Committee

€2M–€10M.

Tier 3 — Functional Leadership

€500K–€2M.

Tier 4 — Operational

<€500K.

This keeps governance proportional.


Material Event Reporting

Some issues should escalate regardless of scheduled board cycle.

For example:

  • missed notice on strategic supplier;
  • major third-party incident;
  • critical transition failure.

Contract Renewal Tracker can flag:

Material Renewal Event

This can trigger immediate executive reporting.


Event-Based Escalation

For example:

IF contract_value > 10M
AND risk = CRITICAL
THEN executive_material_event = TRUE

This creates automatic governance.


Board Reporting by Supplier Concentration

Another useful view:

Top strategic suppliers:

Supplier A:

€40M.

Supplier B:

€28M.

Supplier C:

€20M.

Renewal dates:

visible.

This gives leadership insight into dependence timing.


Board Reporting by Category

For example:

Cloud:

€45M renewing.

Software:

€38M.

Outsourcing:

€30M.

This helps link renewal exposure to strategy.


Board Reporting by Geography

For multinational organizations:

Europe:

€60M.

North America:

€90M.

APAC:

€30M.

Useful when different regional issues exist.


Board Reporting by Legal Entity

This may be relevant where commitments sit across several subsidiaries.

Again, only if material.


Scenario Reporting

The board may need to understand alternative outcomes for major renewals.

For example:

CloudCo:

Option A — 36 Months

€32M.

Option B — 12 Months

€12M but higher annual rate.

Option C — Replacement

€26M + €8M migration.

This provides decision context.


Scenario Risk

Each scenario should show:

  • cost;
  • lock-in;
  • transition risk.

The lowest cost option may not be strategically best.


Major Renewal Business Cases

For very large renewals, a board pack may include a one-page decision summary:

Recommendation

Financial Impact

Risk

Alternatives

Management Decision Required

Contract Renewal Tracker can generate much of the data automatically.


Example

Recommendation

Renew strategic cloud supplier for 24 months.

TCV

€28M.

Supplier Proposal

€32M.

Negotiated Outcome

€28M.

Cost Avoidance

€4M.

Key Risk

Supplier concentration remains High.

Mitigation

Multi-cloud exit roadmap.

This is board-ready.


Savings Reporting Needs Integrity

Avoid presenting:

Supplier proposal €32M.

Final €28M.

as:

€4M “hard savings”

if current comparable cost was:

€27M.

The board should see:

Cost Avoidance: €4M

and:

Spend Increase vs Current: €1M

Both can be true.

This builds trust.


Avoid Double Counting at Board Level

Board reports should never combine:

hard savings

cost avoidance

demand reduction

without clear methodology.

Finance validation should underpin reported figures.


Board Reporting and Auditability

Every summary number should be traceable back to:

contract-level data.

Executives may not drill down often.

But audit and finance teams must be able to.


Board Report Snapshot

When a board pack is generated:

preserve:

  • reporting date;
  • underlying portfolio snapshot;
  • metrics.

This supports historical governance.


Why Snapshotting Matters

If the board asks six months later:

What did we know when we approved this?

The organization can retrieve the exact report context.

This is important for major commitments.


Board Decision Audit Trail

If leadership approves:

a strategic renewal

or:

bridge extension,

Contract Renewal Tracker should preserve:

  • decision;
  • date;
  • terms.

This connects governance directly to execution.


Board Decision → Workflow

Example:

Board approves:

24-month renewal.

Contract Renewal Tracker updates:

Approved Strategy.

Final signature workflow starts.

This reduces manual handoffs.


Executive Committee vs Board

Not every material renewal requires formal board approval.

Some may belong to:

executive committee.

The system should support different governance levels.


Governance Routing

Based on:

  • contract value;
  • strategic criticality;
  • policy.

For example:

€5M:

Executive Committee.

€25M:

Board.

This can be automated.


Board Reporting Frequency

Possible:

monthly

for highly dynamic portfolios.

Quarterly

for many organizations.

The platform should support both:

scheduled

and:

event-driven reporting.


Monthly Management Pack

Useful for:

CFO/Executive Committee.

Board report may be:

quarterly.

Same data, different level of aggregation.


Trend History

The platform can show:

12-month trajectory of:

  • critical exposure;
  • supplier inflation;
  • savings.

This helps leadership evaluate progress.


Example Trend

Critical Renewal Exposure:

Q1:

€52M.

Q2:

€45M.

Q3:

€38M.

This indicates improving control.


Strategic Supplier Concentration Trend

Top 5 concentration:

48% → 45% → 42%.

This may demonstrate diversification.


Savings Trend

Realized savings:

€2M → €3.5M → €4.2M.

This shows financial benefit.


Missed Deadline Trend

Material misses:

3 → 1 → 0.

This is a strong governance improvement metric.


Board-Level Renewal Health Indicator

A simple indicator could summarize:

Financial

Risk

Execution

Control

For example:

Renewal Portfolio Health:

Green / Stable

But it should always be supported by explicit metrics.


Avoid a Black-Box Board Score

One number such as:

87/100

may be visually convenient.

But boards need to understand:

what drives the result.

Use it only as a summary.


Board-Level KPIs

A concise set might include:

Strategic Renewal Exposure

High/Critical Exposure

Budget Variance

Supplier Inflation

Realized Savings

Strategic Supplier Concentration

Material Compliance Exceptions

Decisions Required

These cover most of the board-level story.


AI: “What Should the Board Know?”

A senior executive could ask:

What should I put in the board renewal update?

The assistant could produce:

Three issues are board-relevant this quarter. First, €32M cloud renewal negotiations remain €4M above internal target. Second, the €25M outsourcing replacement is High risk because migration has slipped six weeks. Third, procurement savings remain on track at €5.4M forecast versus €5M target.

This is an excellent executive AI use case.


AI: “What Changed Since Last Board Meeting?”

The assistant might answer:

Critical exposure decreased €14M, but the outsourcing transition moved from Medium to High risk. Renewal budget variance widened from €1.2M to €2M due mainly to software supplier inflation.

This creates concise continuity.


AI: “Which Decision Needs Board Approval?”

For example:

The CloudCo 24-month renewal requires board approval under current authority policy because total commitment is €28M.

This turns governance rules into usable guidance.


AI: “What Is the Biggest Financial Risk?”

Response:

The largest near-term financial risk is the unresolved CloudCo negotiation. Accepting the current supplier proposal would increase two-year commitment by €4M above management target.

This keeps leadership focused.


AI: “What Is the Biggest Operational Risk?”

Response:

The outsourcing replacement currently presents the largest operational risk because replacement readiness is forecast 18 days after incumbent contract expiry.

Again, clear and actionable.


Role-Aware Board Briefing

CFO focus:

  • cost;
  • savings.

CIO:

  • transition;
  • critical suppliers.

General Counsel:

  • notice and compliance.

The platform can produce different briefing views from the same underlying data.


Board Pack Automation

A mature feature could automatically assemble:

  • KPI page;
  • strategic renewal table;
  • commentary;
  • decision requests.

The report remains reviewed and approved by management before distribution.


Board Report Export

Potential formats:

  • PDF;
  • PowerPoint;
  • secure dashboard.

The format matters less than the quality of underlying data and commentary.


Board Reporting ROI

Management reporting often consumes significant time.

Suppose procurement, finance, and legal spend:

40 hours per quarter

creating a strategic renewal pack.

Automation reduces:

40 → 10.

Annual saving:

120 hours.

At €100/hour:

€12,000 productivity value

But as elsewhere, the larger value is better executive decision-making.


One Earlier Executive Intervention Can Be Worth Far More

If the board or executive committee identifies a:

€25M strategic supplier issue

months earlier,

the cost avoidance or risk reduction can substantially exceed the reporting efficiency.

This is why the reporting layer matters.


Board Reporting Makes the Product More Strategic

Operational SaaS often struggles to gain executive visibility.

Board reporting changes that.

When Contract Renewal Tracker provides:

  • supplier concentration;
  • commitment;
  • strategic risk;
  • savings;

the platform becomes relevant to senior governance.

That can materially strengthen enterprise adoption.


Contract Renewal Tracker as an Enterprise Governance Platform

The product evolution becomes:

Renewal Dates

Workflows

Financial Outcomes

Supplier Risk

Executive Dashboards

Board Governance

That is far beyond reminder software.


From Operational Detail to Strategic Narrative

The full process is:

Thousands of Contract Events

Portfolio Aggregation

Materiality Filter

Strategic Exceptions

Board Narrative

Decision

This is exactly what senior leadership reporting should do.


Ready to Bring Strategic Renewals into Executive Governance?

Boards and executive committees should not need to understand the operational mechanics of contract management.

But they should have visibility into:

  • major supplier commitments;
  • financial exposure;
  • strategic dependency;
  • critical renewal risk;
  • significant savings;
  • major exceptions.

Contract Renewal Tracker is designed to translate complex renewal portfolios into concise, board-ready management information.

Use Contract Renewal Tracker to:

  • define materiality thresholds;
  • track strategic renewal exposure;
  • quantify high-risk commitments;
  • monitor supplier concentration;
  • report multi-year obligations;
  • measure supplier inflation;
  • report finance-validated savings;
  • monitor material compliance exceptions;
  • report strategic replacement risk;
  • track forecast ranges and confidence;
  • identify decisions requiring executive approval;
  • preserve historical board snapshots;
  • generate AI-assisted management commentary grounded in actual renewal data.

The objective is to move from:

“The board only hears about supplier renewals when something goes wrong.”

to:

“Leadership sees the material commitments, risks, financial implications, and required decisions early enough to influence the outcome.”

Start Your Contract Renewal Tracker Subscription →


Final Thoughts

Board-level renewal reporting is not about showing more data.

It is about filtering the portfolio to the handful of issues that matter most.

The process should convert:

Contracts

Materiality

Financial Exposure

Strategic Risk

Decision

The strongest board reporting answers four questions:

What is changing?

What is material?

What is the risk?

What decision is required?

For Contract Renewal Tracker, this creates another important commercial step.

The platform can begin as a tool that helps individual teams avoid missed renewal dates.

It can grow into the system leadership uses to understand strategic supplier commitments before those commitments become financial or operational surprises.

That is a much stronger enterprise proposition.


Next Article in the Contract Renewal Tracker Series

Article 72 — “Contract Renewal KPI Framework: The 25 Metrics Every Procurement, Finance, Legal, and Contract Operations Team Should Track”

The next article will consolidate many of the metrics developed throughout the series into one practical measurement framework. It will cover renewal exposure, decision coverage, notice compliance, auto-renewal exposure, cycle time, approval SLA, savings, cost avoidance, supplier inflation, forecast accuracy, supplier performance, data quality, termination execution, transition success, concentration, and renewal ROI.

This should be a strong search and conversion article because it provides prospects with a practical measurement framework while naturally demonstrating how Contract Renewal Tracker can become the system that calculates and monitors those KPIs automatically.

Contract Renewal Tracker is launching its first SaaS beta on September 21, 2026. The beta is designed to help businesses move beyond spreadsheets and manual reminders by bringing contract renewals, notice deadlines, ownership, and upcoming actions into one dedicated platform. Be among the first to know when Contract Renewal Tracker becomes available and get early access to the beta release. Notify Me When the Beta Launches (One email only — no newsletter or ongoing marketing emails.)

Discover more from Contract Renewal Tracker

Subscribe now to keep reading and get access to the full archive.

Continue reading
